"Repair time" also isn't "power restoration time." Utilities may reroute loads, assign a spare or bring in a mobile substation long before the original unit is permanently fixed.
This article walks through the framework: identify the fault, decide whether the unit is repairable, complete the repair and testing safely, and know when replacement is the more practical path.
Key Takeaways
- Oil leaks and external components usually take hours to days; windings, core, tank and fire damage take far longer.
- A compatible spare and ready crews shorten the timeline; custom manufacturing and transport extend it.
- No transformer should be re-energized until inspections, tests and safety approvals are complete.
- A qualified assessment gives a better estimate than size or outage length.
What Determines How Long Transformer Repair Takes?
A "blown transformer" isn't a diagnosis. It could mean a fuse, connection, bushing, cooling component, oil leak, insulation failure, winding fault or tank damage. Each carries a different timeline.
Fault severity and repairability
No authoritative US source publishes a general repair-duration range for minor versus major faults, so treat any fixed number with caution. Still, the pattern is consistent:
- External or auxiliary issues (loose connections, damaged terminations, failed fans, accessible seals) are usually the fastest to address.
- Internal arcing, winding damage, core displacement, severe insulation breakdown, fire or tank rupture can require extensive testing, factory repair or replacement.
Field-level leak repairs sit at the short end of the range. According to Transmission & Distribution Services (TDS), typical times include:
- 4-bolt flange repair: about two hours
- 8-bolt flange repair: about three hours
- Dresser coupling: four to eight hours
- CT junction block: six to eight hours (requires an outage)
For factory work, Hitachi Energy says distribution and small-power workshop repairs can take 3-5 weeks in some cases, depending on scope. That page covers 315 kVA to 5 MVA units, not large power transformers.
Transformer type, size and operating role
Distribution, pad-mounted, industrial, generator step-up (GSU) and large substation units differ in access, lifting needs, oil volume, protection systems and parts. One example: a DOE Paducah inventory lists two substation transformers holding 5,054 gallons of oil each.
Standardization matters most. GAO has found that custom designs and nonstandardization limit spare interchangeability, and size and weight constrain transport.
Site, logistics and safety constraints
Weather, site access, cranes, road permits, working space, spill containment, outage coordination and high-voltage test specialists all affect the schedule.
Safety steps are schedule stages, not delays. Lockout/tagout, grounding, arc-flash controls (OSHA 1910.269, 1910.333 and NFPA 70E) and oil-spill rules under EPA's SPCC regulation apply. Final engineering sign-off comes last.
Repair time versus restoration time
Customers can be back on within hours while the failed unit sits untested. Restoration options include feeder transfers, a spare transformer, a mobile substation or load prioritization. A short outage doesn't mean the transformer was repaired.

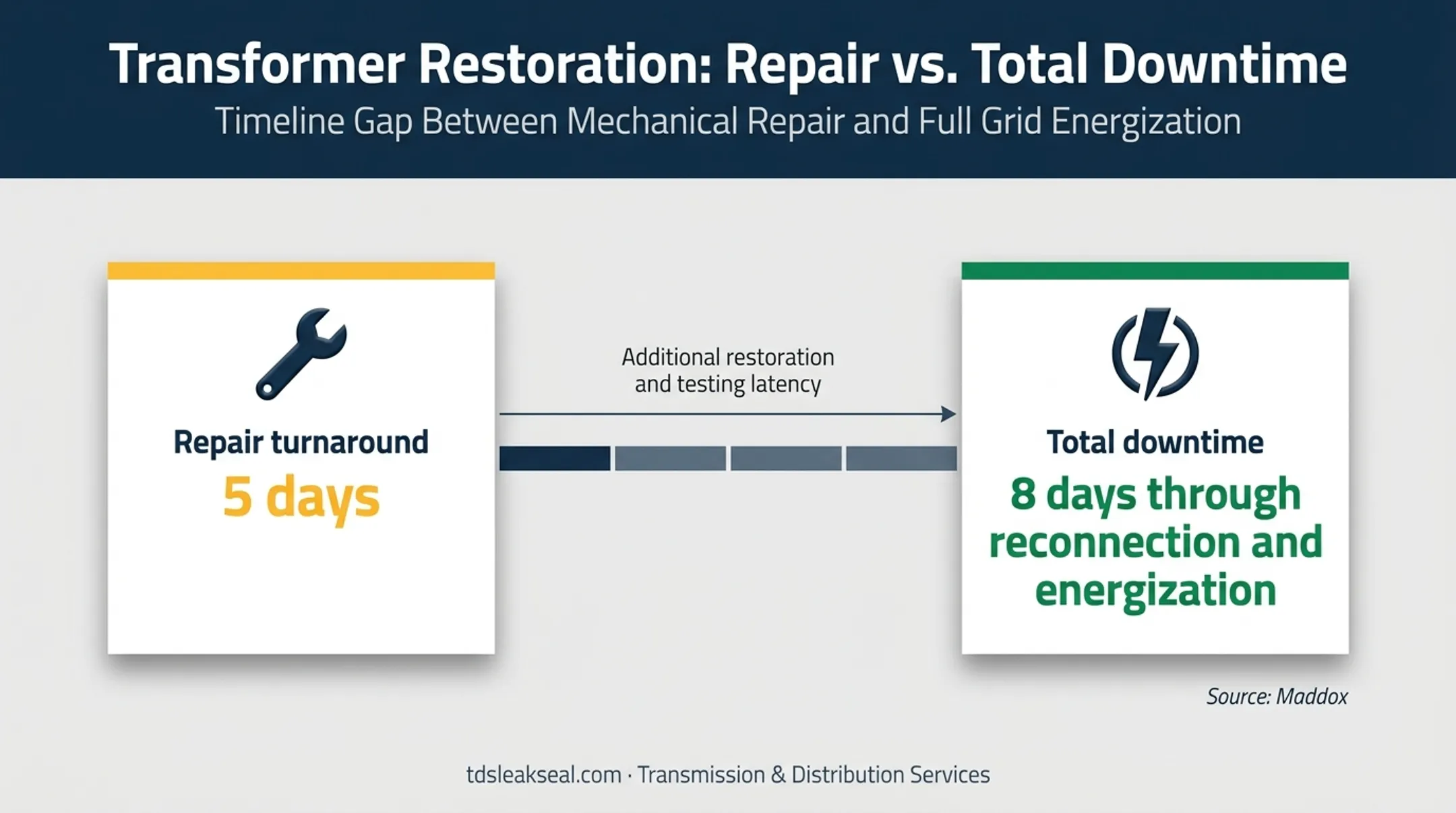

A real example: Maddox reported a 5-day repair turnaround on a leaking 2,500 kVA substation transformer, but 8 days of total downtime through reconnection and energization.

What Happens During Transformer Repair?
Crews start with site control and safety:
- Secure the area and isolate the equipment
- Verify zero energy
- Contain oil or fire hazards
- Review relay and SCADA data
- Document visible damage
Diagnosis and repair planning
Diagnostics narrow the fault to external, localized or internal:
- Visual inspection and nameplate review
- Protection records and infrared thermography
- Insulation resistance, turns ratio and winding resistance tests
- Dissolved gas and oil analysis
Most electrical tests can be run in the field. Oil sample analysis adds laboratory time. These steps have no fixed timeline, so ask your contractor for a scoped schedule.
For leaks, the first step is pinning down the source. A flapper-valve leak may come from the flange gasket, the stem or both, and TDS uses oil leak detector spray to show which.
Repair execution
Component repairs can include:
- Replacing a bushing
- Correcting a connection
- Fixing cooling equipment
- Sealing a localized leak
- Processing contaminated oil
Larger jobs often require draining and filtering oil, disassembly, specialist lifting, factory work, new components, drying, reassembly and further inspection. Conventional leak repair often means de-energizing, grounding and draining radiators, and sometimes the main tank.
Testing and return to service

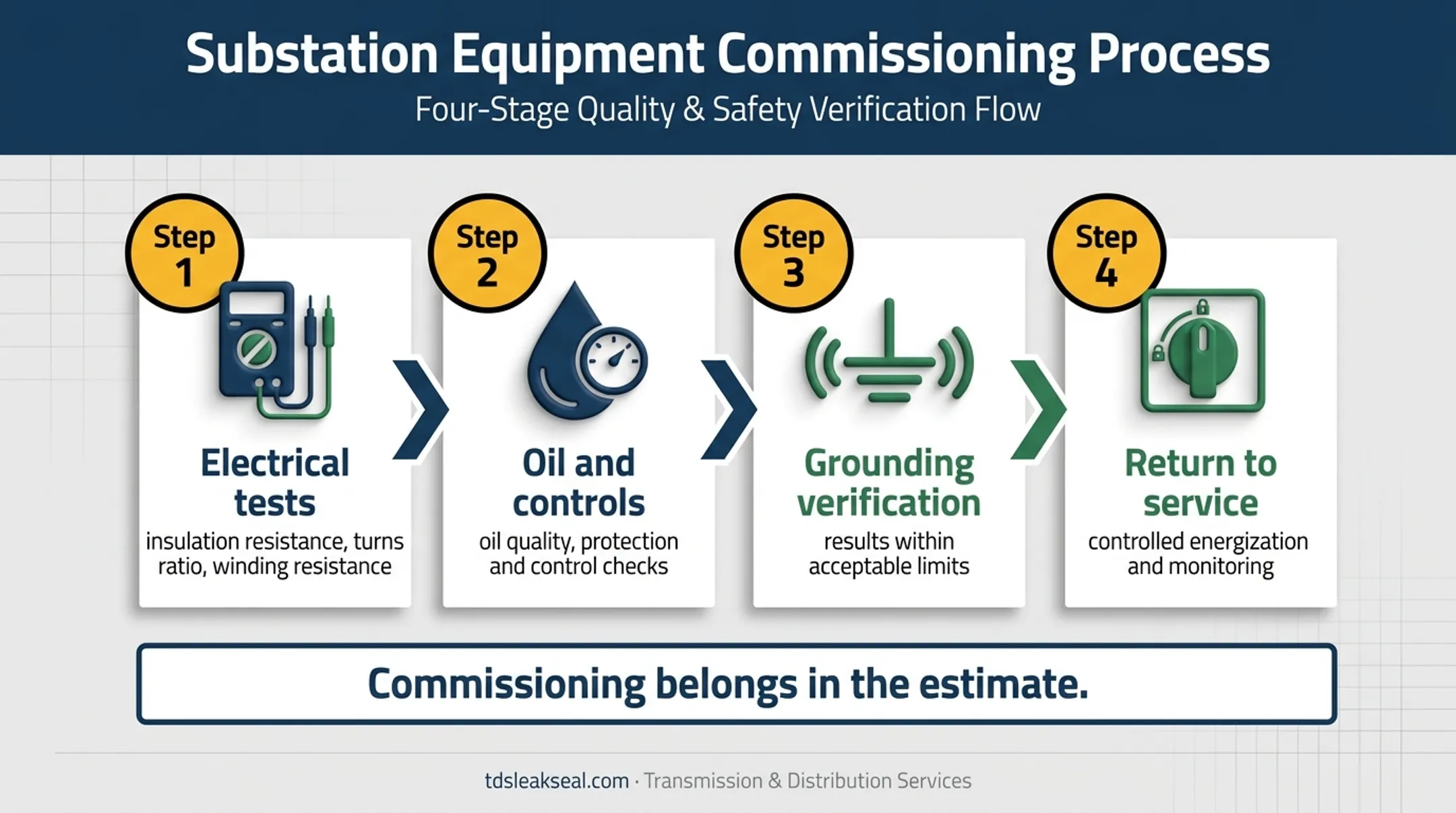

After repair, expect insulation resistance, turns ratio, winding resistance, oil quality, protection and control checks and grounding verification. Results must fall within acceptable limits before energization, according to an IEEE-hosted presentation. Controlled energization and monitoring follow. Include commissioning in any realistic estimate.

Information needed for a credible estimate
Send your contractor:
- Transformer type, nameplate data, voltage and capacity
- Fault alarms and outage history
- Photos, leak location and oil condition
- Recent test results
- Site access limits
- Whether a spare or alternate feed exists
That detail helps sort the job into emergency repair, planned-outage repair, leak sealing, factory repair or replacement.
Repair or Replacement: Which Path Takes Longer?
The choice rests on several factors:
- Damage severity and equipment age
- Safety and expected reliability
- Cost, spare availability, and downtime impact
When on-site repair may be practical
On-site repair can fit when the core, windings, tank, and primary insulation are intact. Typical candidates include:
- Localized oil leaks and seals
- Replaceable bushings and terminations
- Cooling issues and control components
The plan should confirm the root cause, not just treat the symptom, and finish with testing.
Where low-pressure leak sealing may fit
TDS specializes in low-pressure leak sealing for oil- and SF6-filled substation apparatus. It does not rewind or rebuild catastrophically damaged transformers.
When the leak location and equipment condition allow, its cured-in-place gasket method avoids traditional disassembly. Many repairs, especially bottom flange leaks, can be done energized if site conditions, safety procedures, and engineering approval permit. Upper leaks near bushings may require de-energizing and grounding.
TDS offers a free equipment survey and a four-year leak-seal warranty. Confirm the terms for your specific job.
When replacement or factory repair is more appropriate
Replacement or factory repair is more appropriate when you face:
- Severe winding or core damage
- Major arcing, fire, or tank rupture
- Repeated failure, obsolete parts, or unsafe condition
Hitachi says a factory assessment establishes root cause and delivery date.

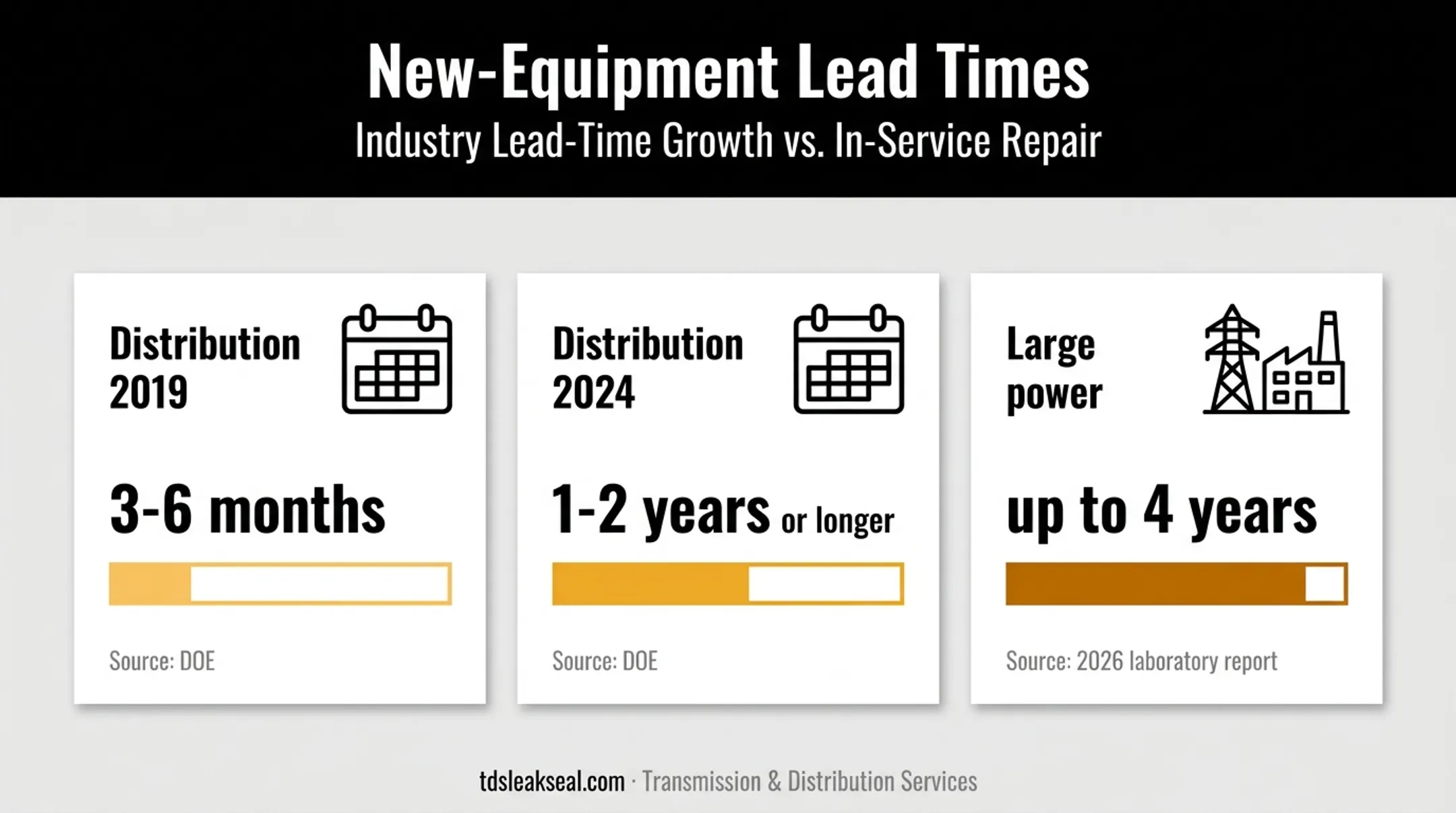

Sourcing often takes longest. DOE reports distribution-transformer lead times of 1-2 years or longer in 2024, up from 3-6 months in 2019. A 2026 laboratory report cites large power transformer lead times up to 4 years. Those are new-equipment figures, not repair times.

Temporary restoration while permanent work continues
GAO describes temporary options such as:
- Load transfers and alternate feeders
- Trailer-mounted mobile substations
- Moving a transformer from a less critical site
These depend on system design, capacity, protection coordination, and approvals. A temporary fix is not a tested, warrantied permanent repair.
How Facilities Can Reduce Transformer Downtime
Facilities shrink repair delays when records, spares, and inspections are ready before a failure. Prioritize these steps:
- Keep nameplate records, drawings, test histories, oil data, spare-part lists, and emergency contacts current
- Build a critical-spares strategy, standardize specs, preplan cranes and transport, and contract qualified testing and repair crews
- Inspect regularly, catch oil leaks early, run thermal or electrical tests when needed, and investigate abnormal alarms promptly
A leak survey is a practical first move. TDS's free survey photographs each leak and lists the location, equipment, repair method, itemized cost, and outage requirements. Maintenance crews can also keep oil leak detector spray on hand for routine checks.
Conclusion
Transformer repair may take hours, days, weeks or longer. The real answer depends on the fault, equipment class, site, parts, safety requirements and testing scope.
Get a qualified assessment, then ask which path fits: component repair, low-pressure leak sealing, temporary restoration, factory repair or replacement.
Frequently Asked Questions
How long does it take to fix a transformer when the power goes out?
Power often returns before the transformer is permanently repaired. Timing depends on fault severity, transformer type, spare availability, site access and utility procedures.
What is the most common cause of transformer failure?
It varies by equipment and environment. CIGRE's survey of 964 major failures mainly cited windings, tap changers and bushings; that data is international and historical, not a U.S. ranking.
How long is the lifespan of a transformer?
GAO says proper maintenance can support many decades of life. Actual life depends on design, loading, temperature, insulation condition, environment and failure history.
What does "transformer outage" mean?
It means the transformer is unavailable or de-energized. Customers may regain power through alternate circuits or temporary equipment while the transformer itself remains out.
Can a transformer be repaired without replacing the entire unit?
Yes, for localized leaks, bushings, connections, controls and cooling components. Core, winding, fire or tank damage may require factory repair or replacement.
How can utilities reduce transformer downtime after a failure?
Keep critical spares and accurate records, test preventively, preplan logistics and line up repair partners. Get an early technical assessment and consider temporary restoration.
